4 October 2024    Crew: GaryM, TomG, KentS, StuJ

Gunnison

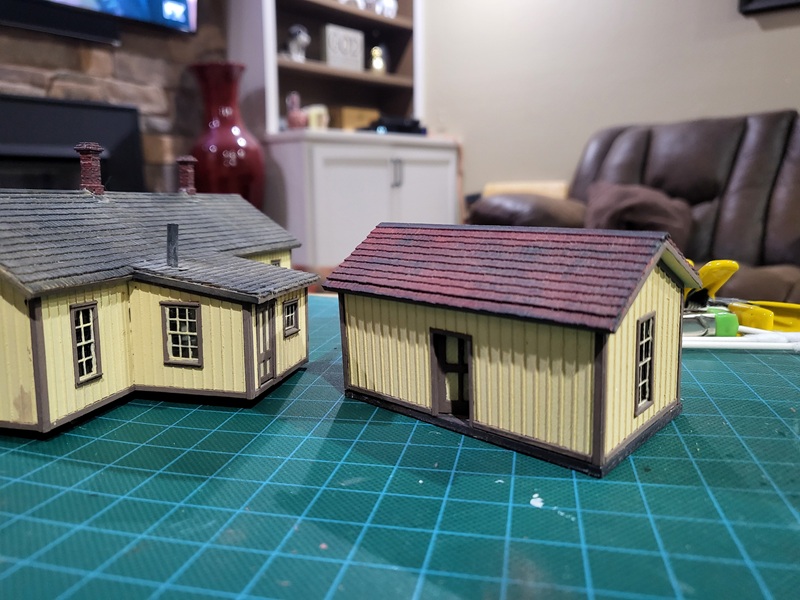

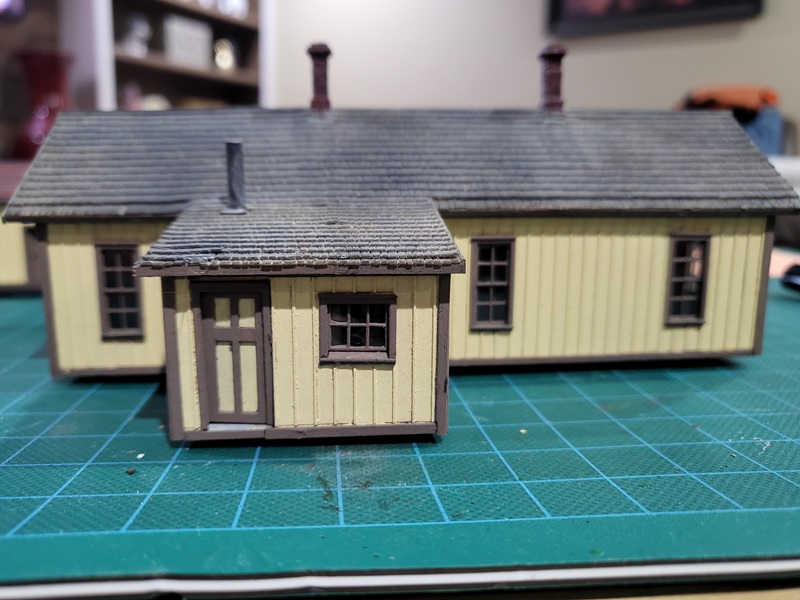

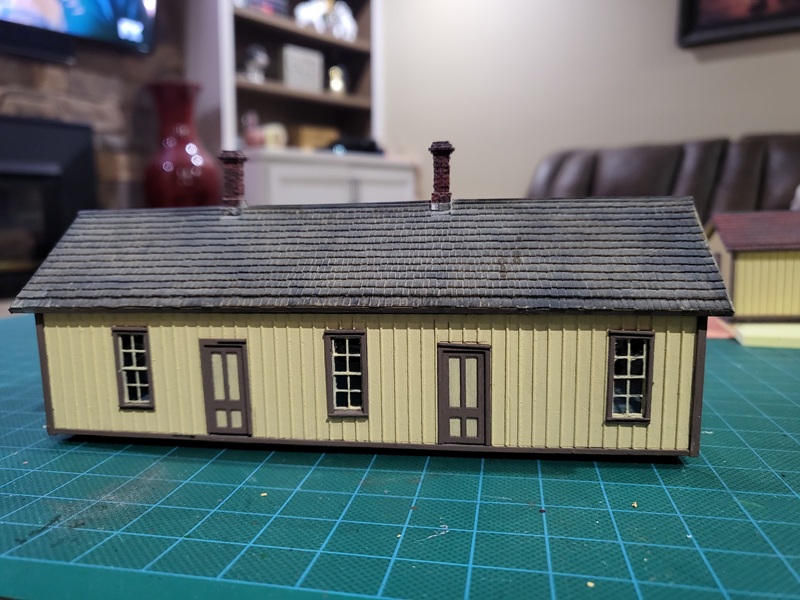

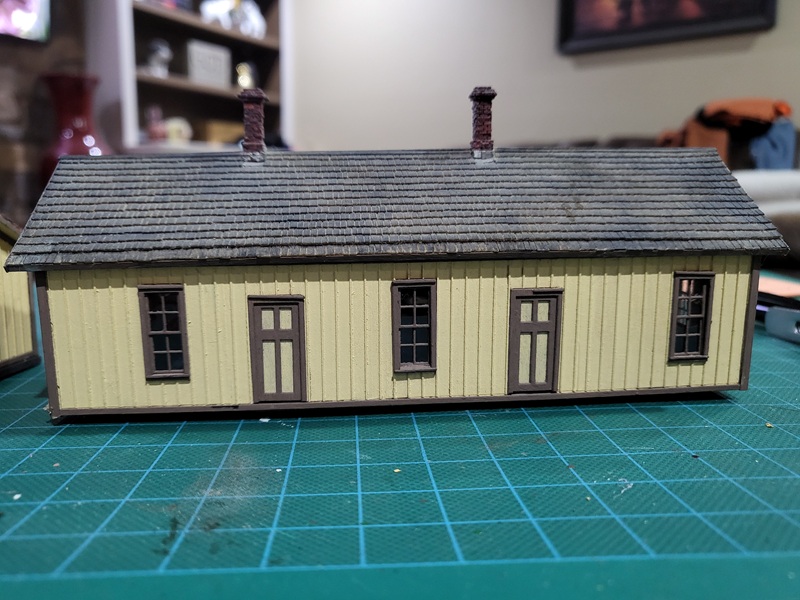

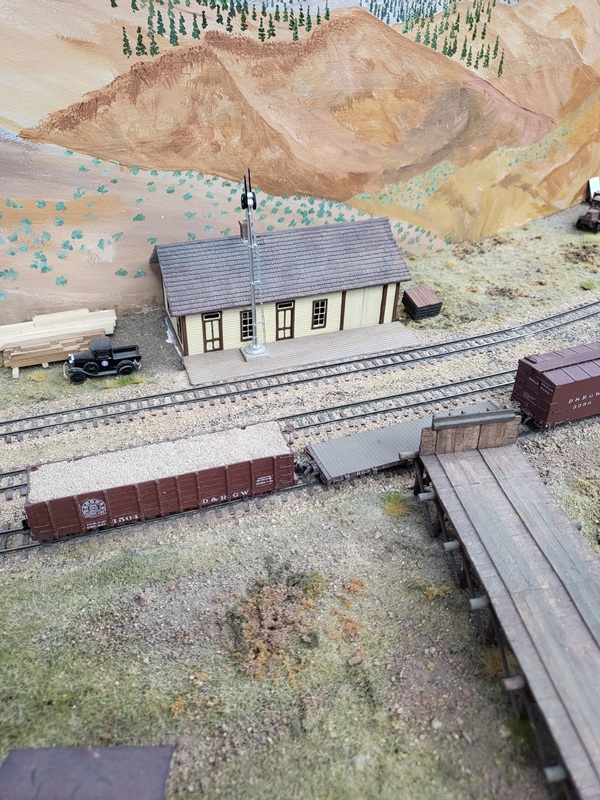

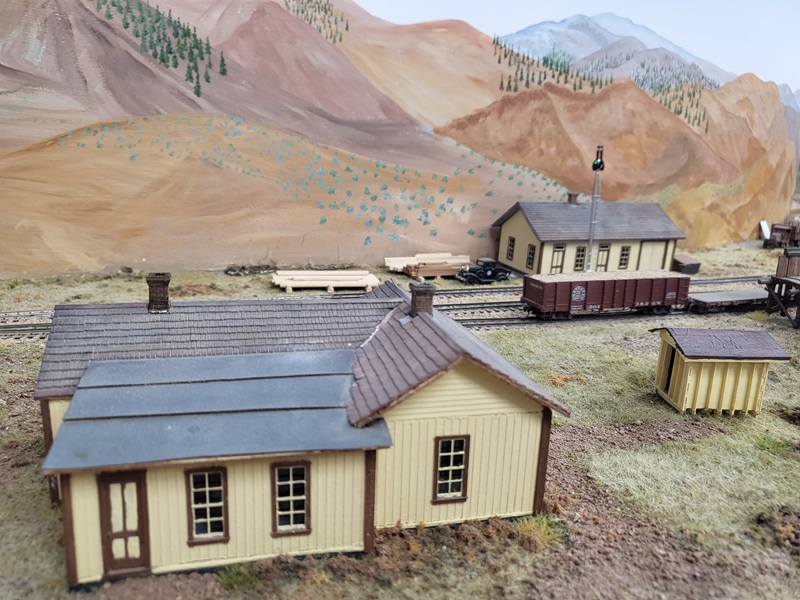

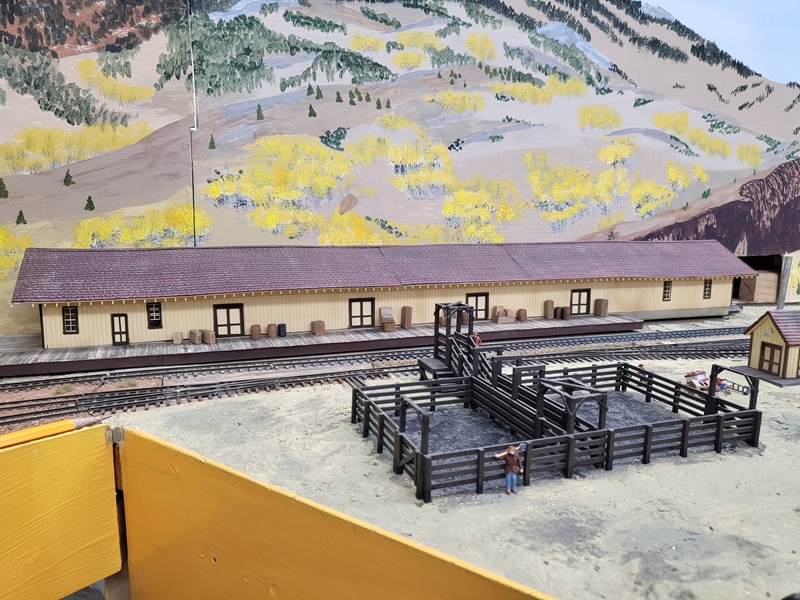

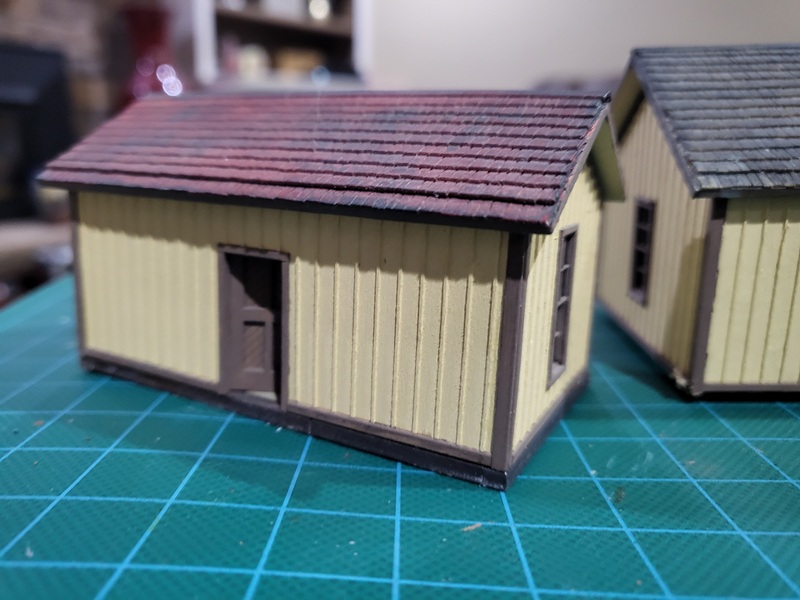

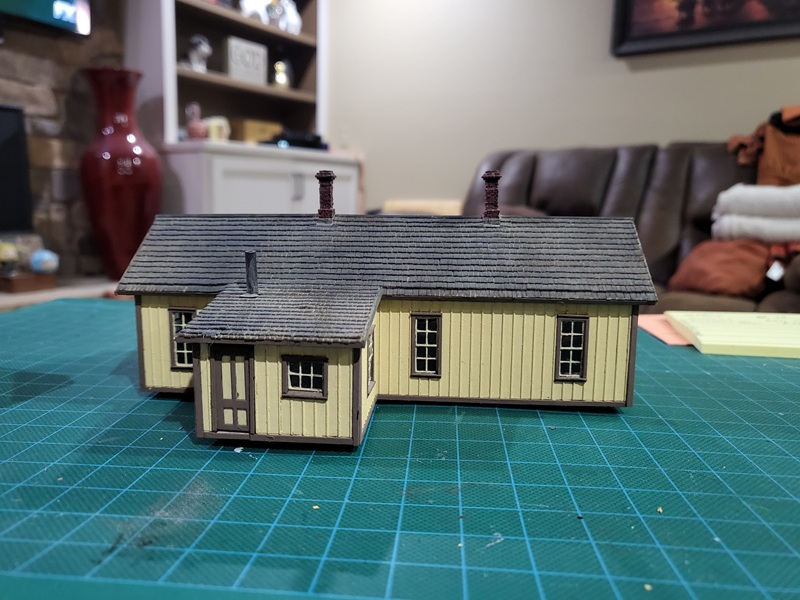

GaryM noticed several buildings with unpainted mullions and even door panels upside down, and underwent repainting. StuJ did the same for the freight house, which really made those details pop! KentS built a backdrop for the throughway to the Baldwin Branch. TomG imstalled the the stockpen and scenicked the interior.

31 August 2024    Crew: GaryM, TomG, KentS, StuJ

Gunnison

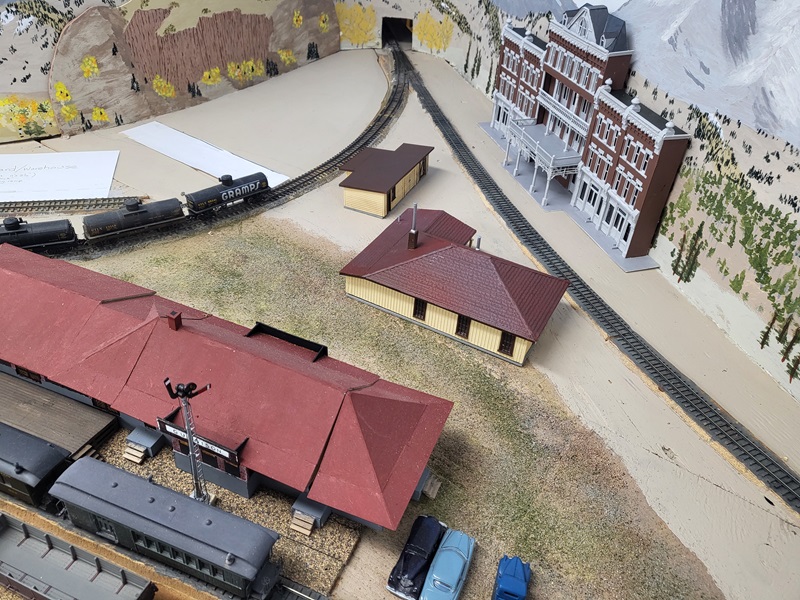

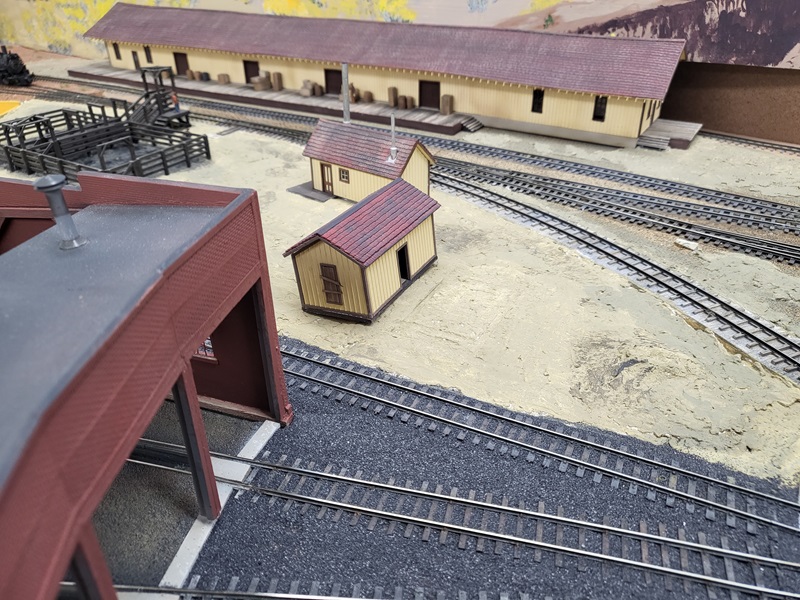

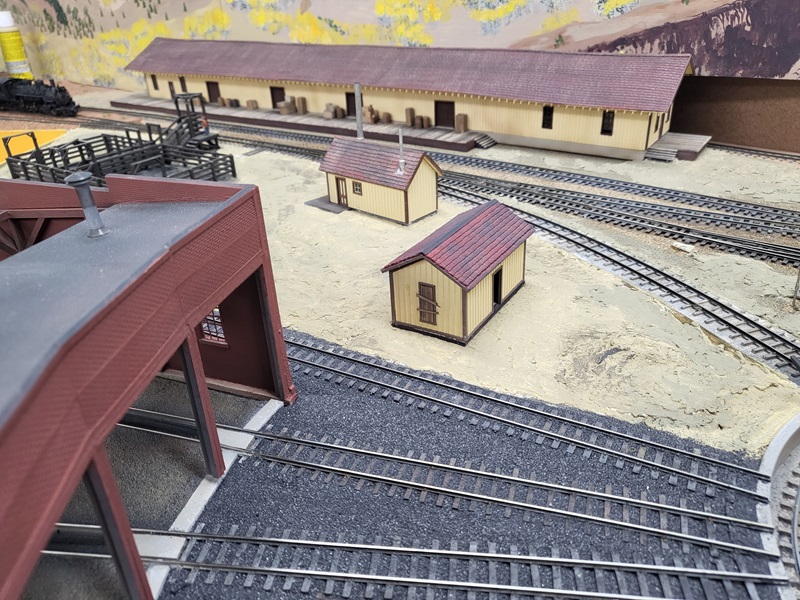

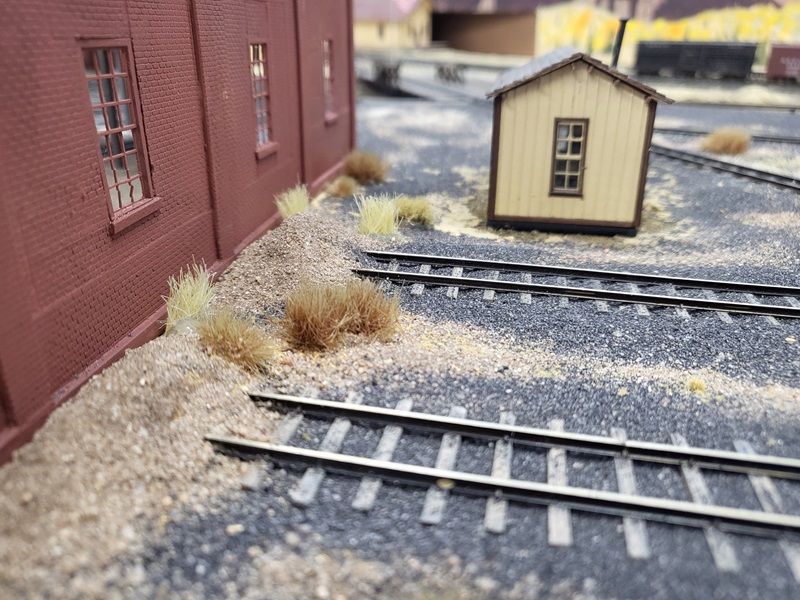

StuJ's Depot eating house and sheds complete. TomG's begun scenicking near the roundhouse and has the roundhouse tracks ballasted.

17 August 2024    Crew: GaryM, TomG, KentS, StuJ

Gunnison

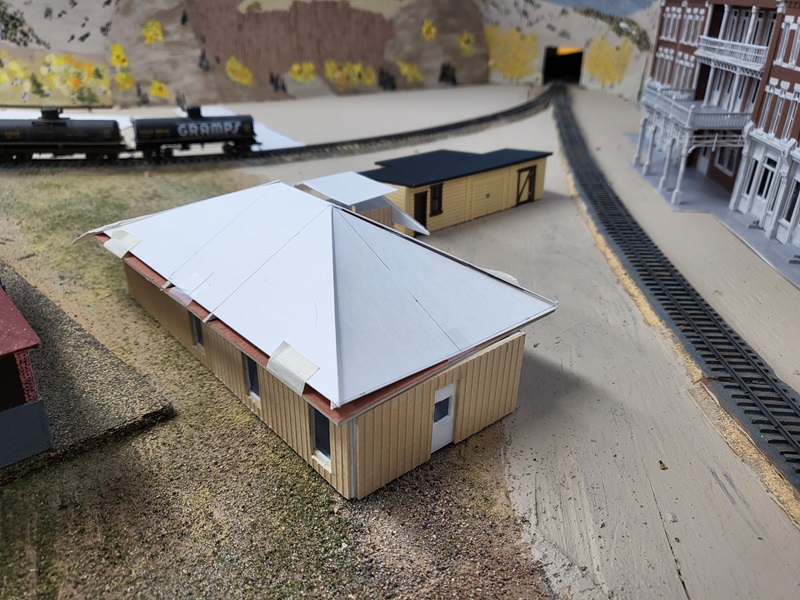

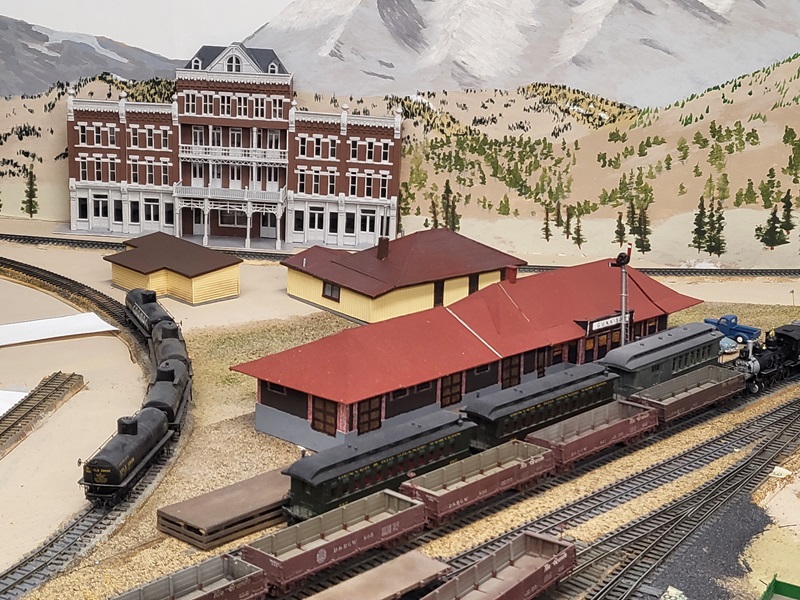

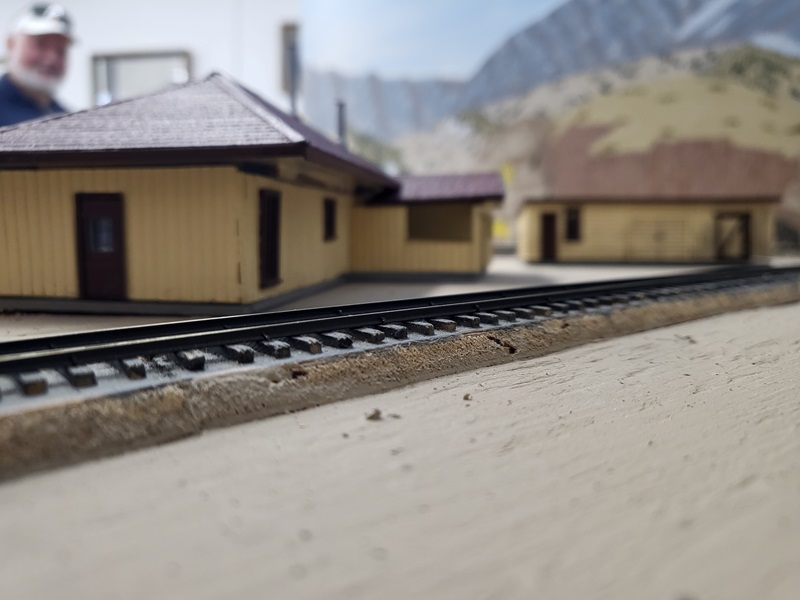

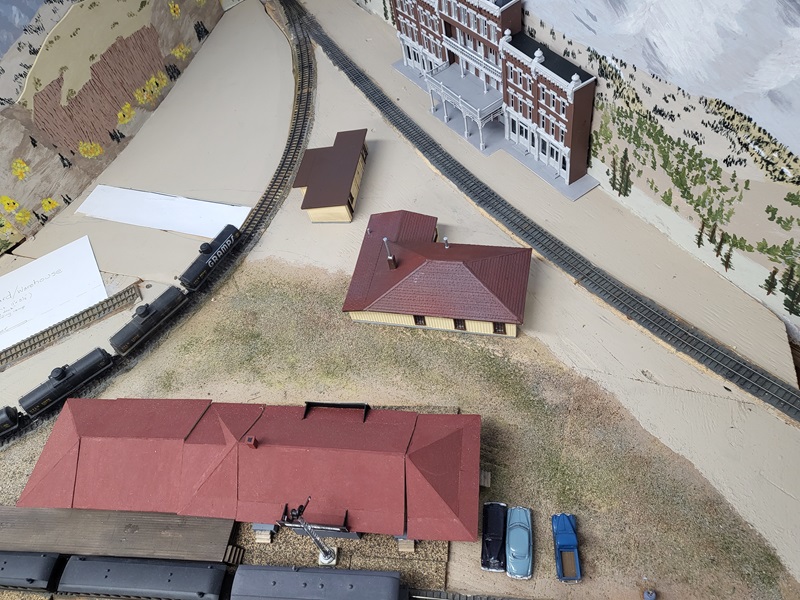

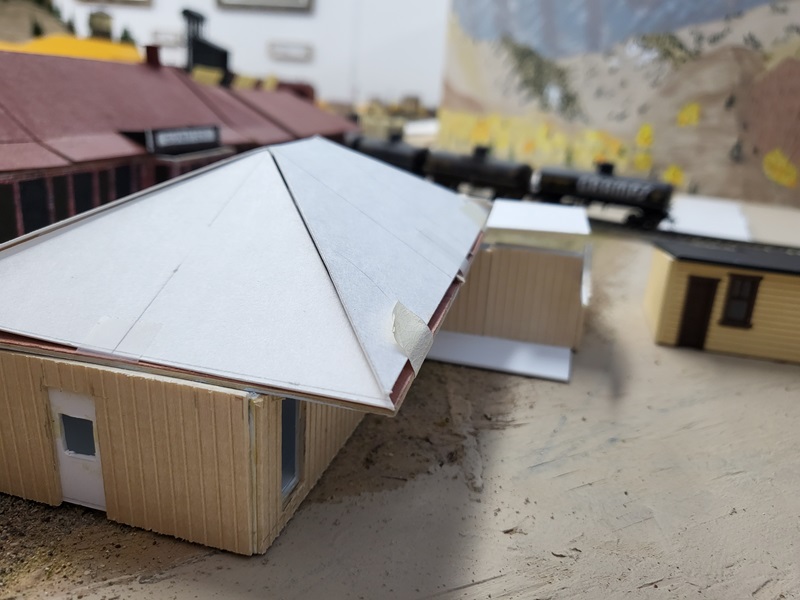

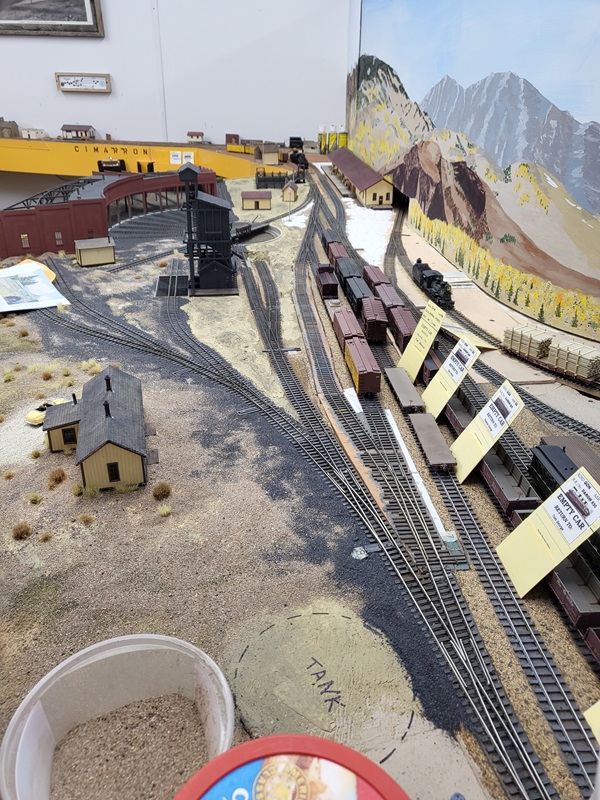

StuJ is working on the eating house and sheds behind the depot. You can see StuJ's completed freight house, and TomG's repaint of the coaling tower in the middle photo. GaryM mounted new carcard holders.

15 June 2024    Crew: GaryM, TomG, KentS

Gunnison

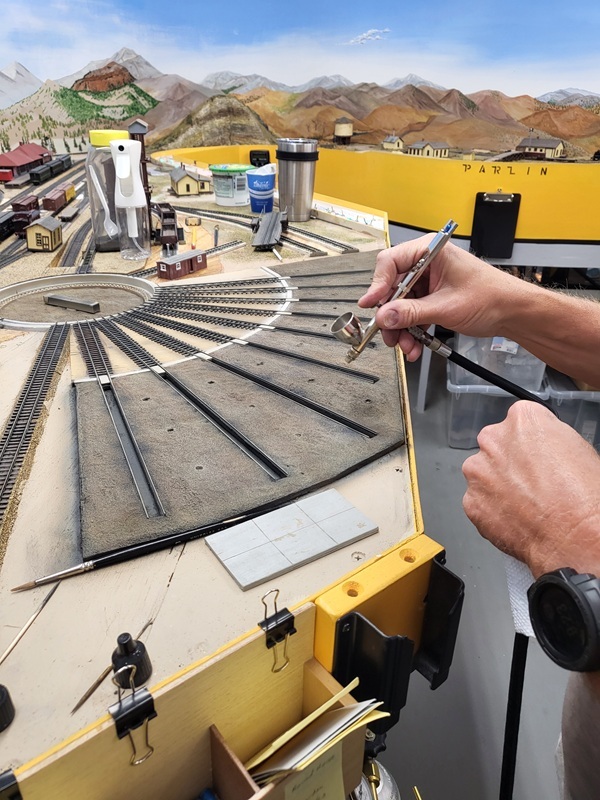

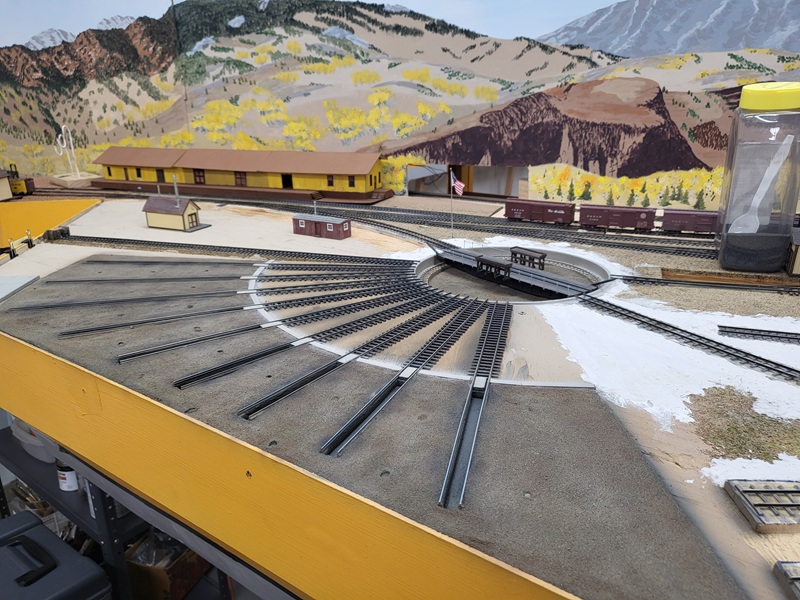

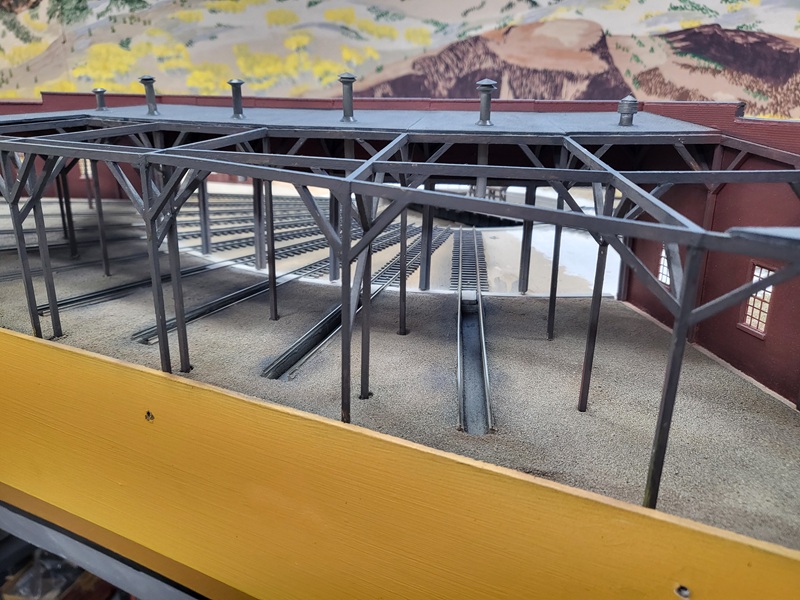

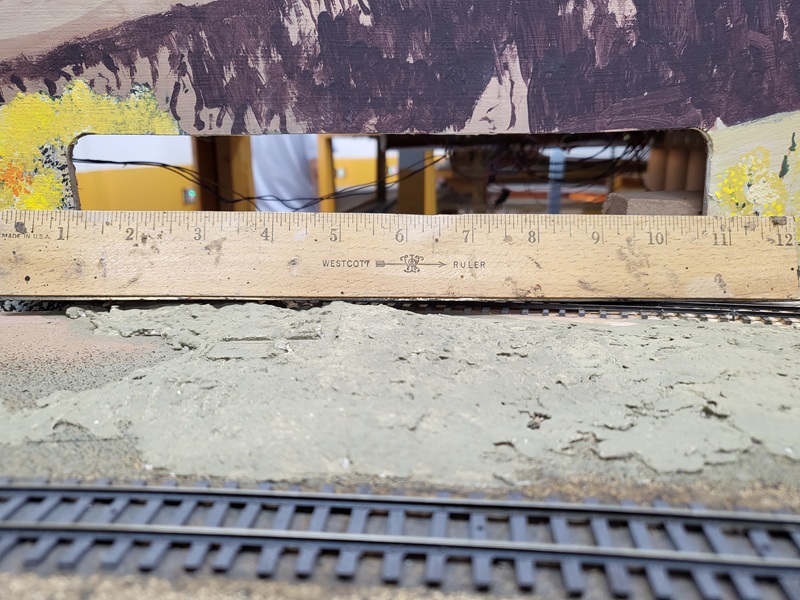

TomG worked on the dirt floor of the roundhouse, and started sculpting the grounds around the turntable and coaling tower.

18 May 2024    Crew: GaryM, TomG, KentS

Salida

Poncha Junction

11 May 2024    Crew: GaryM, TomG, KentS

Salida

8 May 2024    Crew: GaryM, TomG, KentS

Gunnison

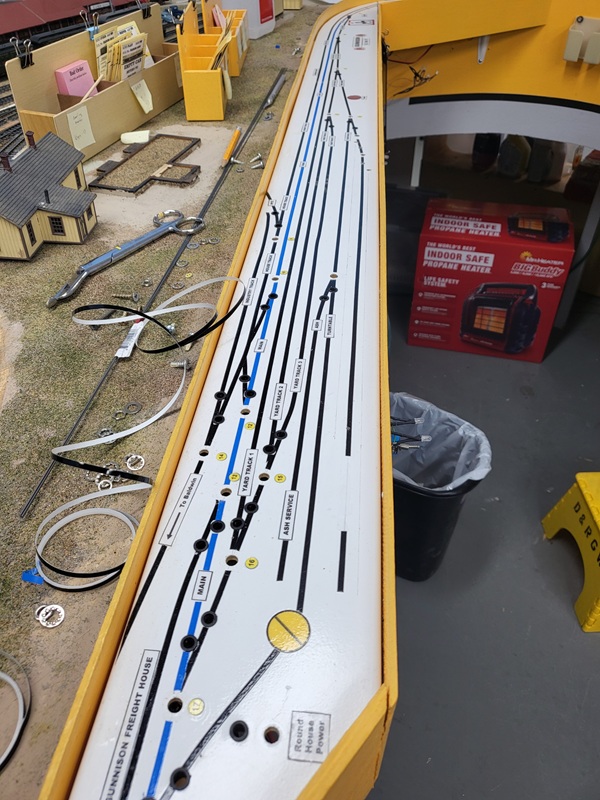

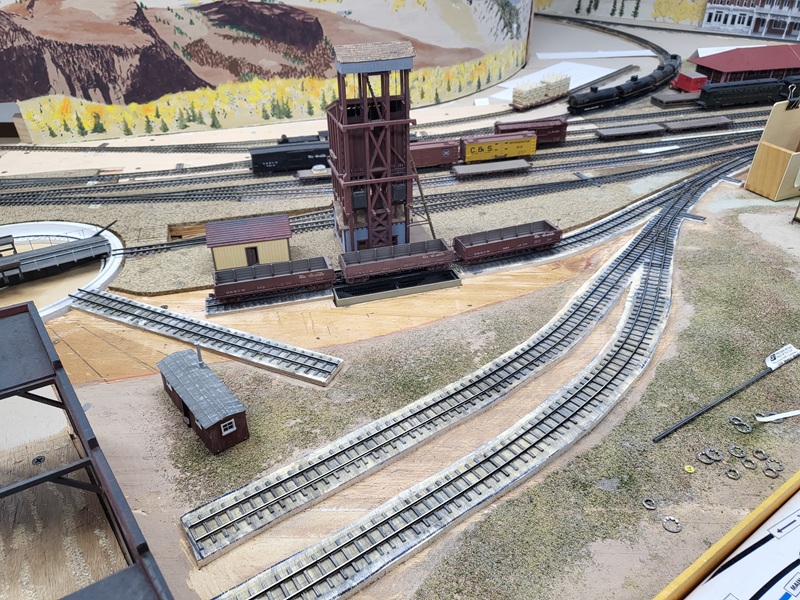

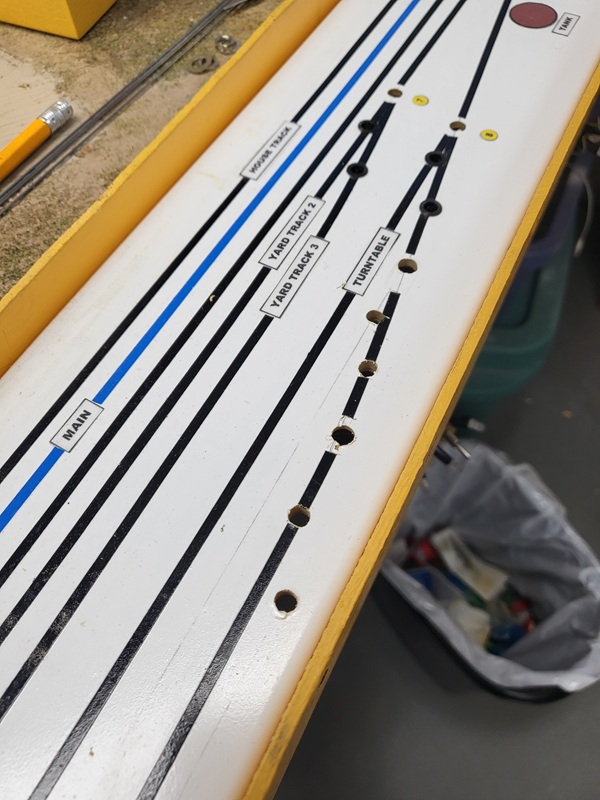

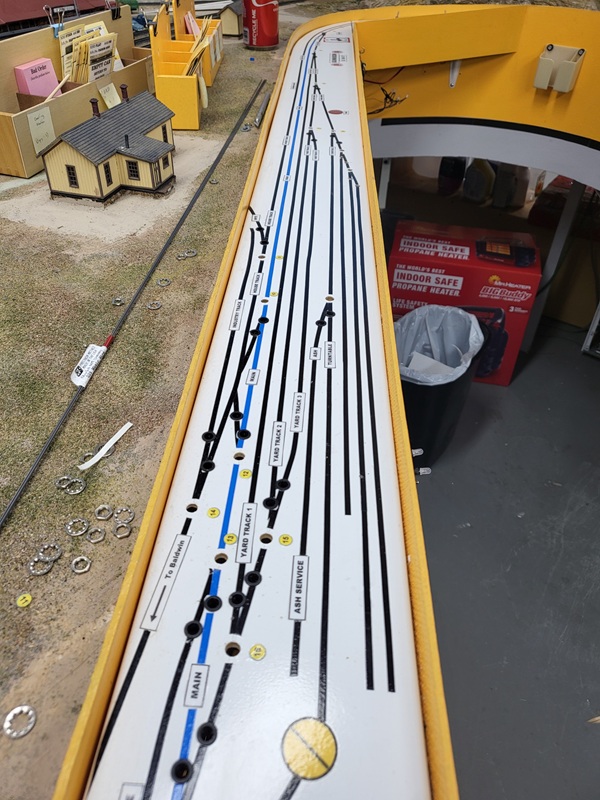

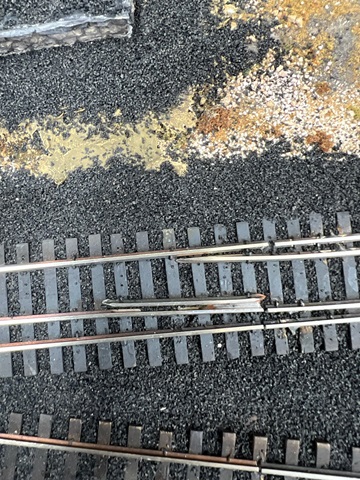

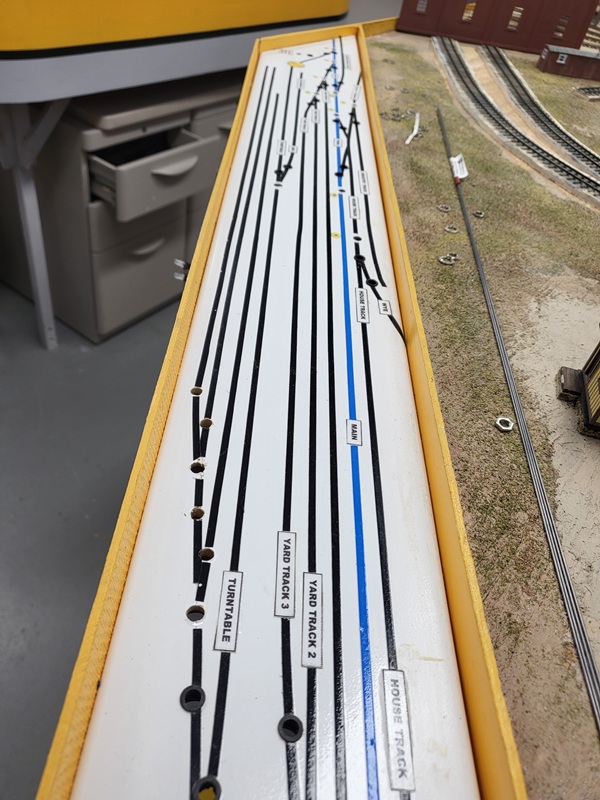

TomG finished laying the rails on the work car track, new garden track, and coaling tower. GaryM finshed installing new switch panels with new track layout, ready for KentS to install toggles and LEDs.

13 April 2024    Crew: GaryM, TomG

Gunnison
TomG replaced the No. 4 Shinohara with a handlaid No. 6 to the turntable.

6 March 2024    Crew: GaryM, TomG

Gunnison

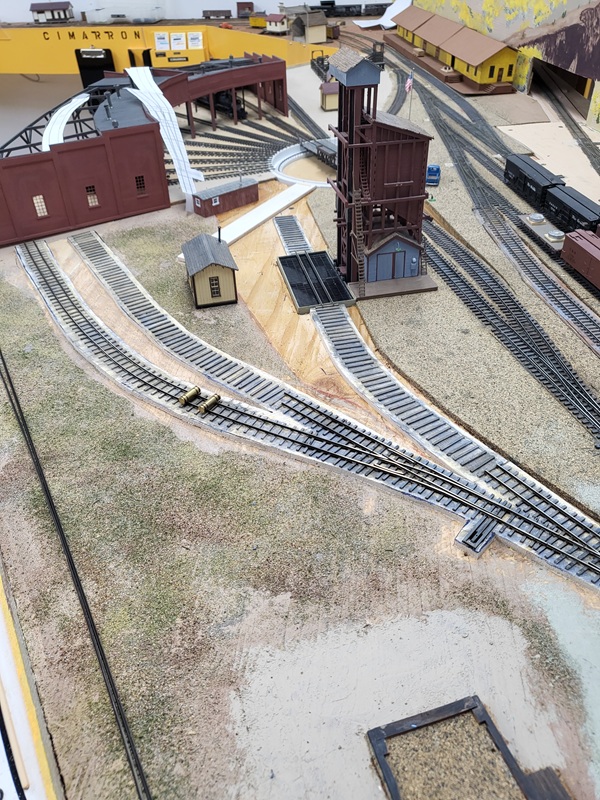

TomG laid out the new garden track to the turntable for another work car. Rails to the first new track have been laid.

28 February 2024    Crew: GaryM, TomG

Gunnison

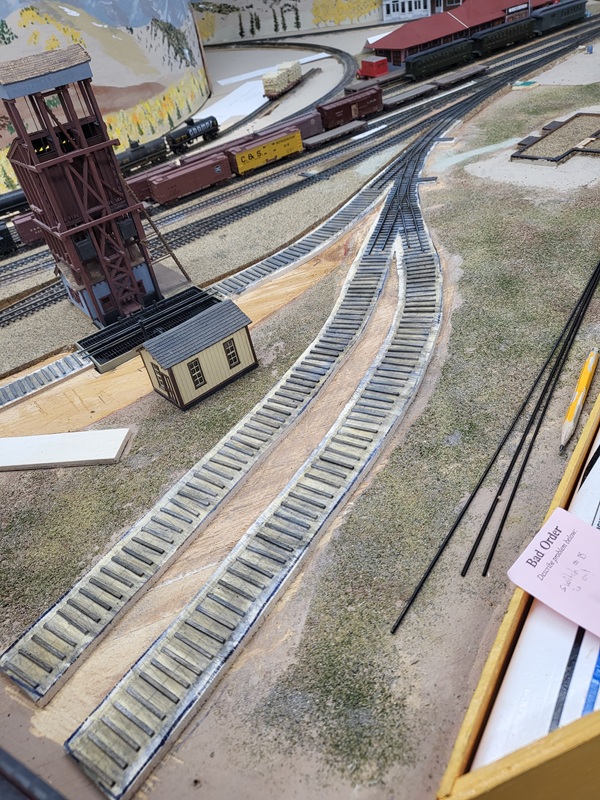

TomG added the switches and roadbed for the two new tracks to the yard for the rotary train and work cars. The rails to the coaling tower were removed to be replaced.

24 February 2024    Crew: GaryM, StuJ

Gunnison

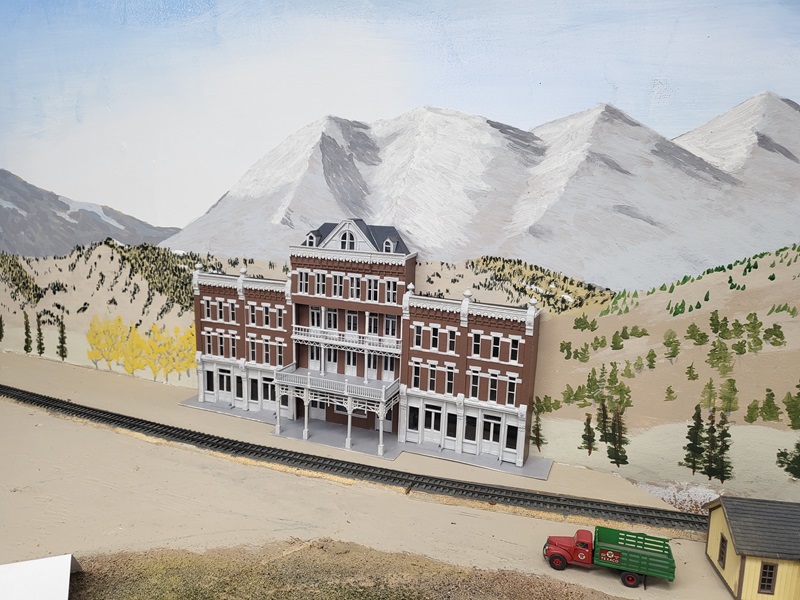

StuJ brought out his scratchbuilt La Veta hotel backdrop.

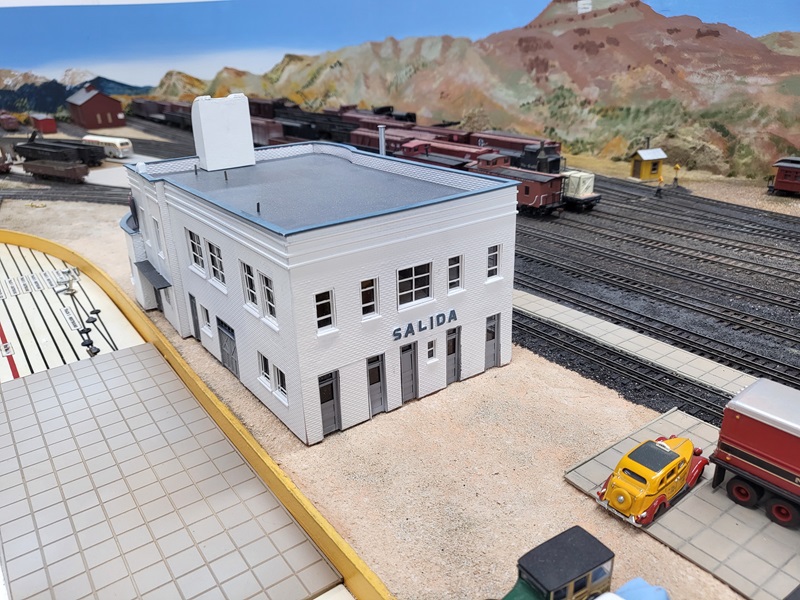

3 February 2024    Crew: GaryM

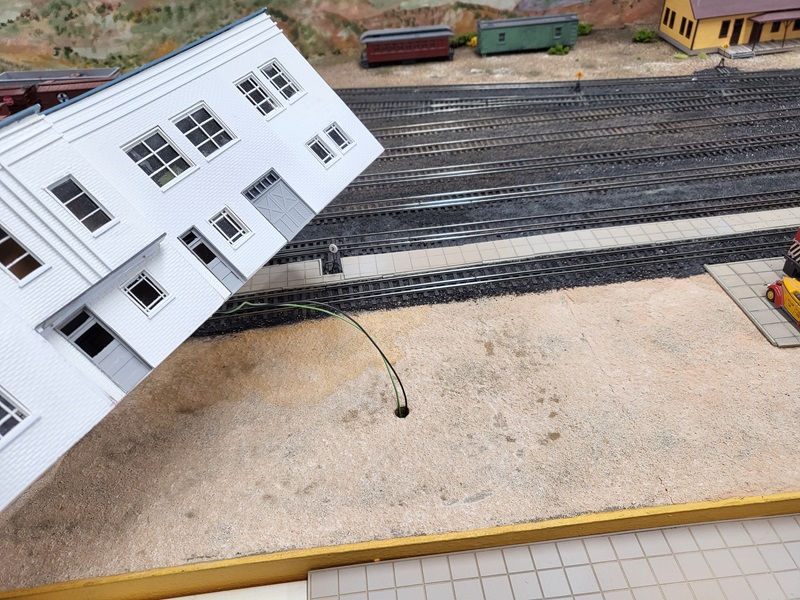

Salida
Drilled a locating hole for the Art Deco Depot wiring. This hole was located at the west end of the removable "concrete platform" that is only used for the Monte Christo hotel (pre-1941). Use caution for moving the 1941 Art Deco Depot.

31 January 2024    Crew: GaryM, KentS, TomG, DaveG, LiamW, & GrantC

Salida

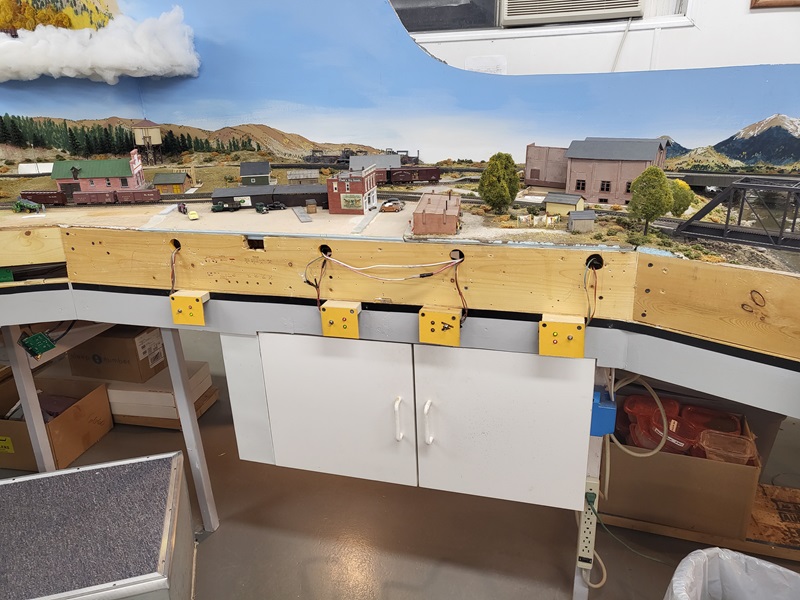

KentS finished the benchwork on West Salida, mounting the extended surface, cutting down the fascia on the Arkansas River and replacing fascia.

Parkdale

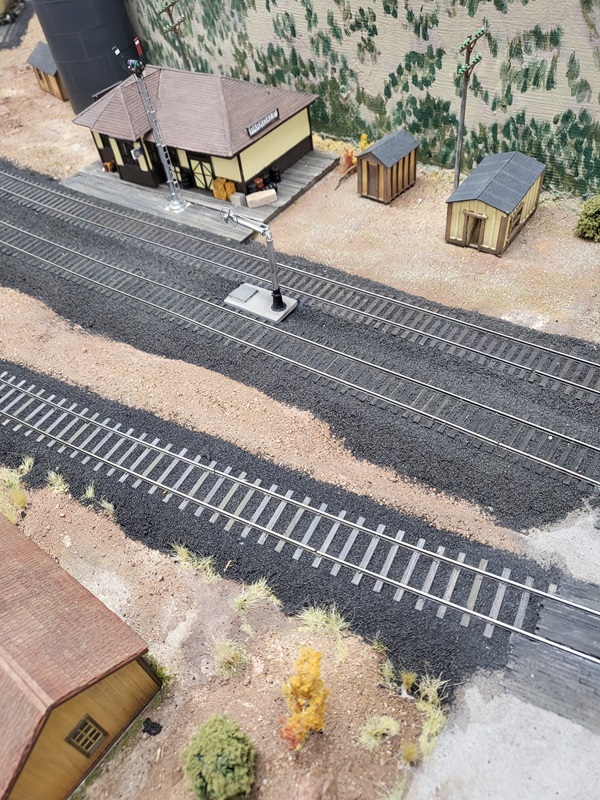

TomG installed the water spout by digging out some ballast and setting the foundation down to tie level. Previously, the foundation was too high and getting snagged by some engines.

Extras:

  • TomG tested out Westside K-36 (to be #483) for KentS at Monarch switchback.

  • Setting up trains on staging for test runs is the next step for getting back to Operating Sessions.

27 January 2024    Crew: KentS, TomG, StuJ

Salida

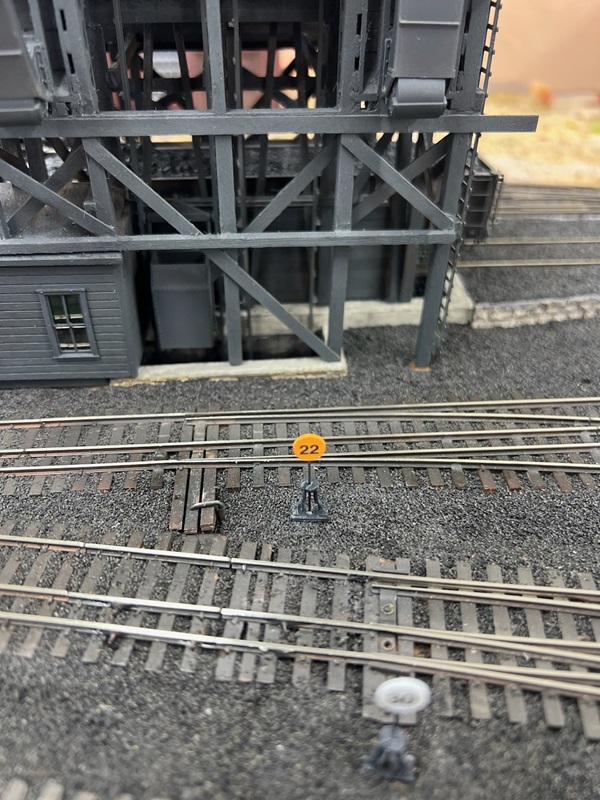

TomG repositioned Switchstand 22 because it was getting caught by some engines on the switch next to the coaling tower. The SG engines bumped through the Turntable transition rails which needs addressing. KentS built the framing for the scenery extension in West Salida.

Gunnison
StuJ brought out theis scratchbuilt La Veta hotel backdrop front that he has been working on, for a test fit.

24 January 2024    Crew: KentS, TomG, GaryM, LiamW, DanielS

Salida
A few more patches of ballast repair and spot track cleaning. KentS removed the fascia on West.

Gunnison
TomG installed the ballast board for the MOW tracks.

Jack's Cabin

20 January 2024    Crew: GaryM, GerryG, GlennG, KentS, GrantC & GaryMe

Salida

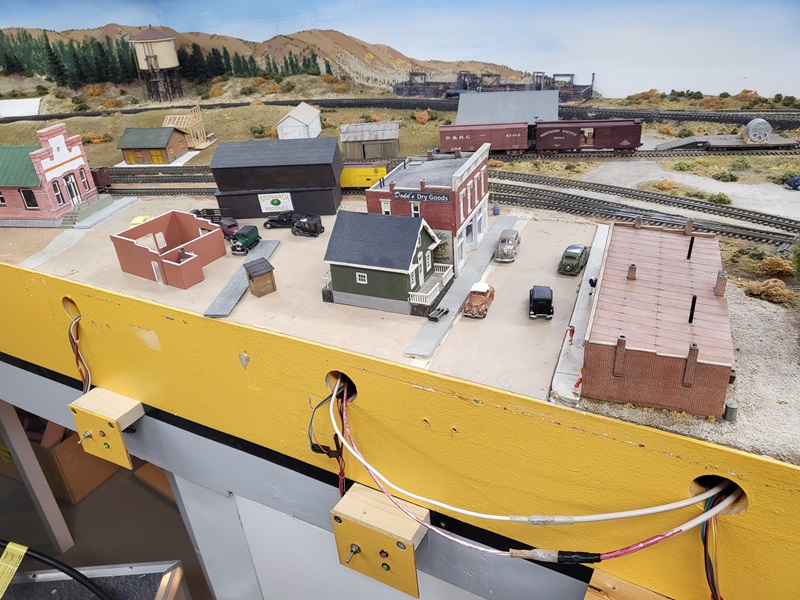

KentS tore off the West Salida switch panel, temporarily remounted each switch toggle so track remains fully operational. GlennG came out to layout the buildings on the south side of first street. GaryM worked on some track cleaning and ballast patching along the mainline.

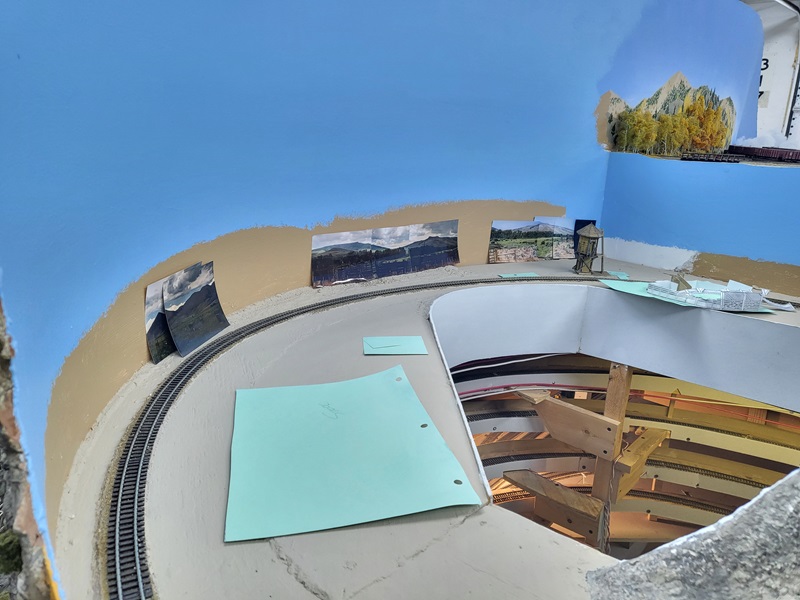

Jack's Cabin
GaryMe repainted the backdrop blue in the helix, laid out templates for the stock pens, tank(s), pumphouse, and depot (car body).

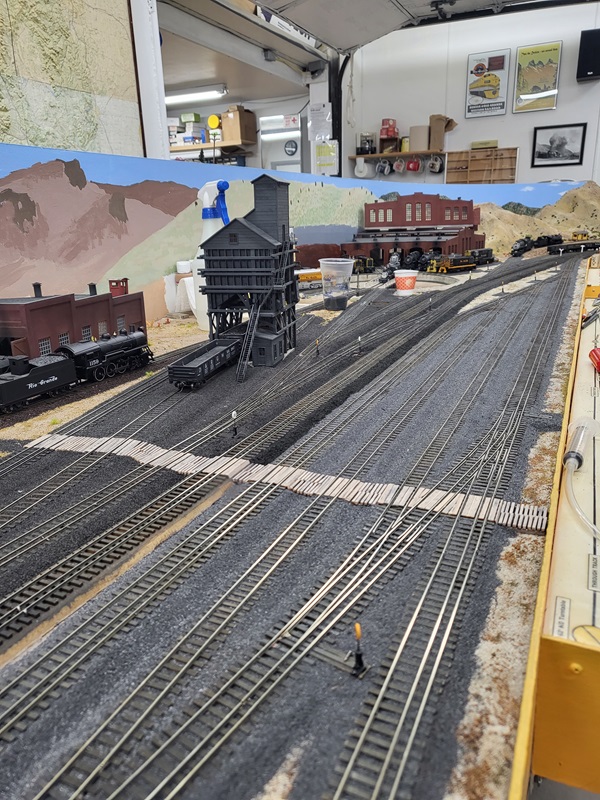

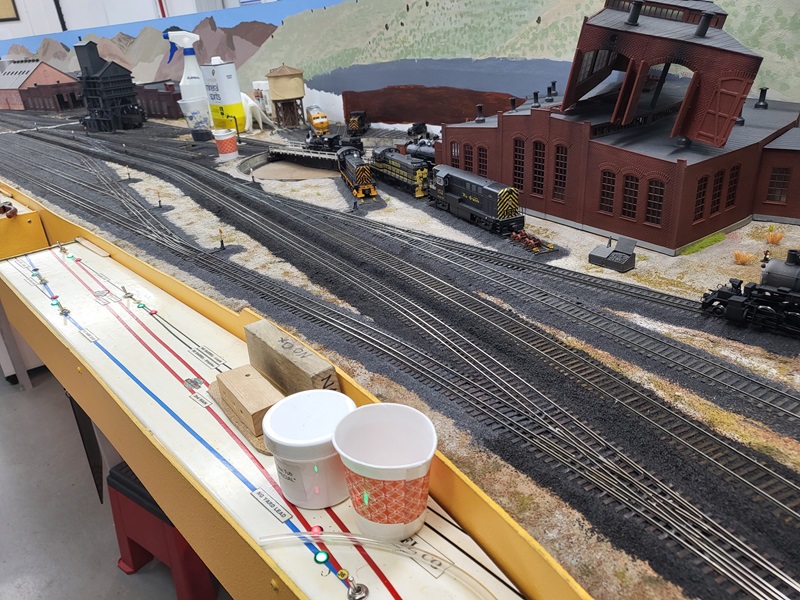

10 January 2024    Crew: GaryM, TomG

Salida

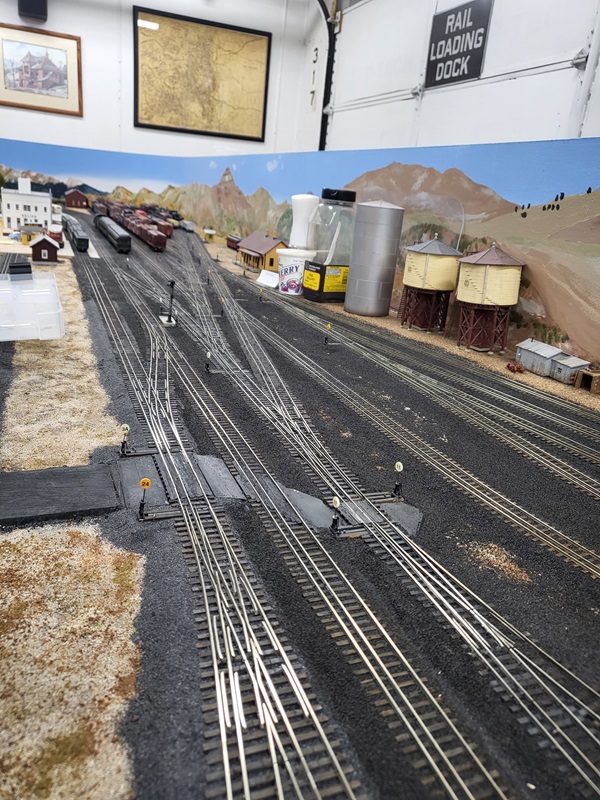

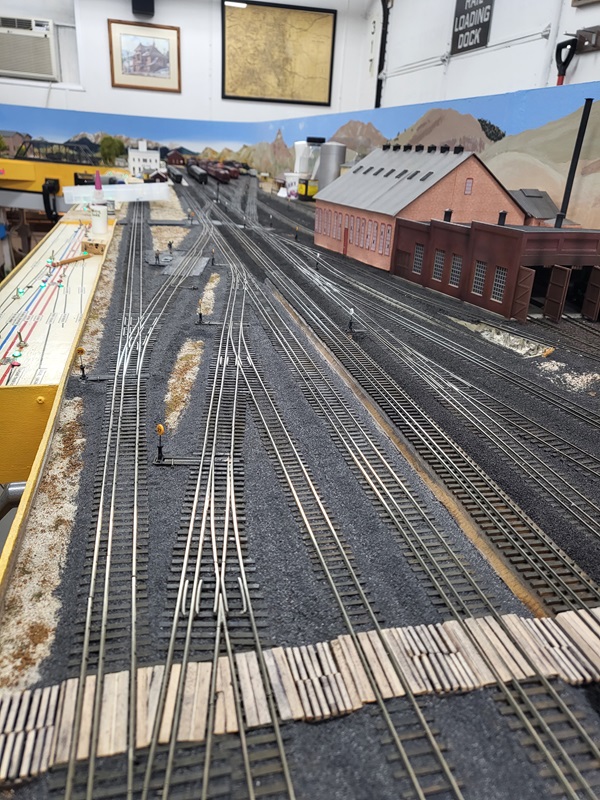

TomG installed switchstands throughout the mainlines and yards. GaryM continued ballast patching.

06 January 2024    Crew: GaryM, GerryG

Shawano

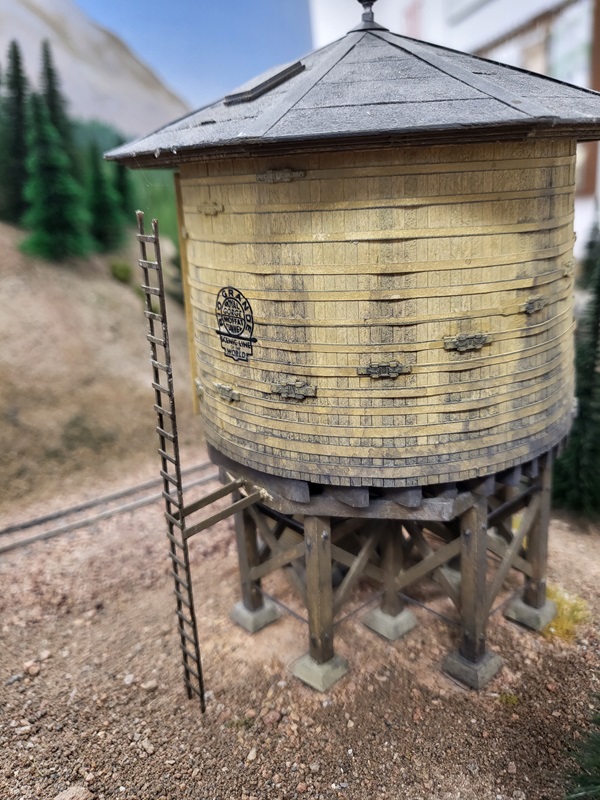

Damaged ladder on tank.

Crested Butte
GerryG worked on the backdrop.

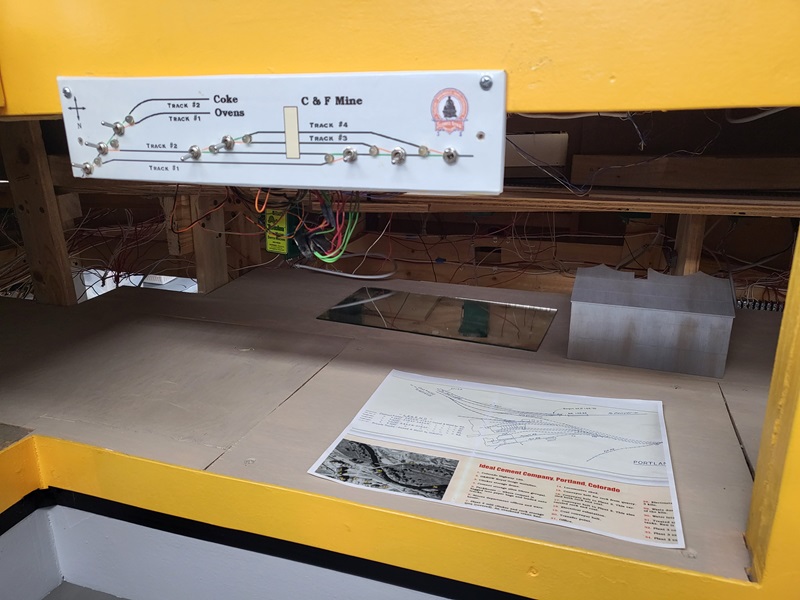

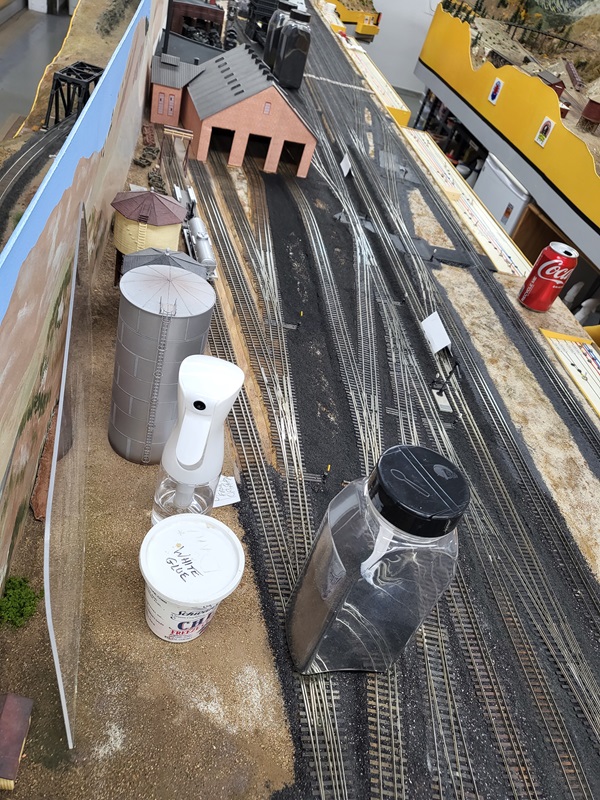

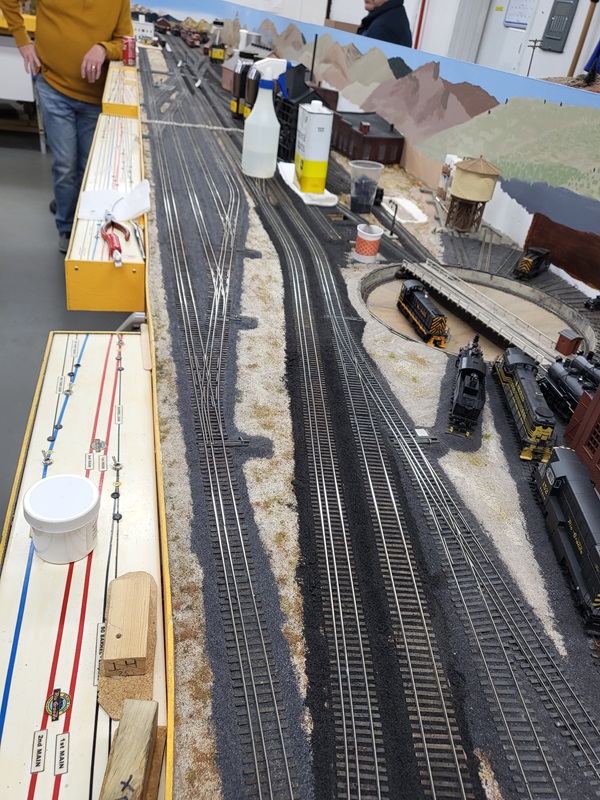

03 January 2024    Crew: GaryM, TomG, DanielS

Portland
DanielS painted the ground.

Salida
More ballasting of the mainlines.

2023 Status Reports
2022 Status Reports2021 Status Reports2020 Status Reports2019 Status Reports
2018 Status Reports2017 Status Reports2016 Status Reports2015 Status Reports
2014 Status Reports2013 Status Reports2012 Status Reports2011 Status Reports
2010 Status Reports2009 Status Reports2008 Status Reports2007 Status Reports

Return to Scenic Line Modeler's Home           This page last modified 20 January 2024.
